Projects

Plants we have built, and what each one had to solve.

Selected work from 100+ MWp commissioned across 22 Indian states and five countries — rooftop, ground mount, and plants we own and operate ourselves.

Three plants, in detail.

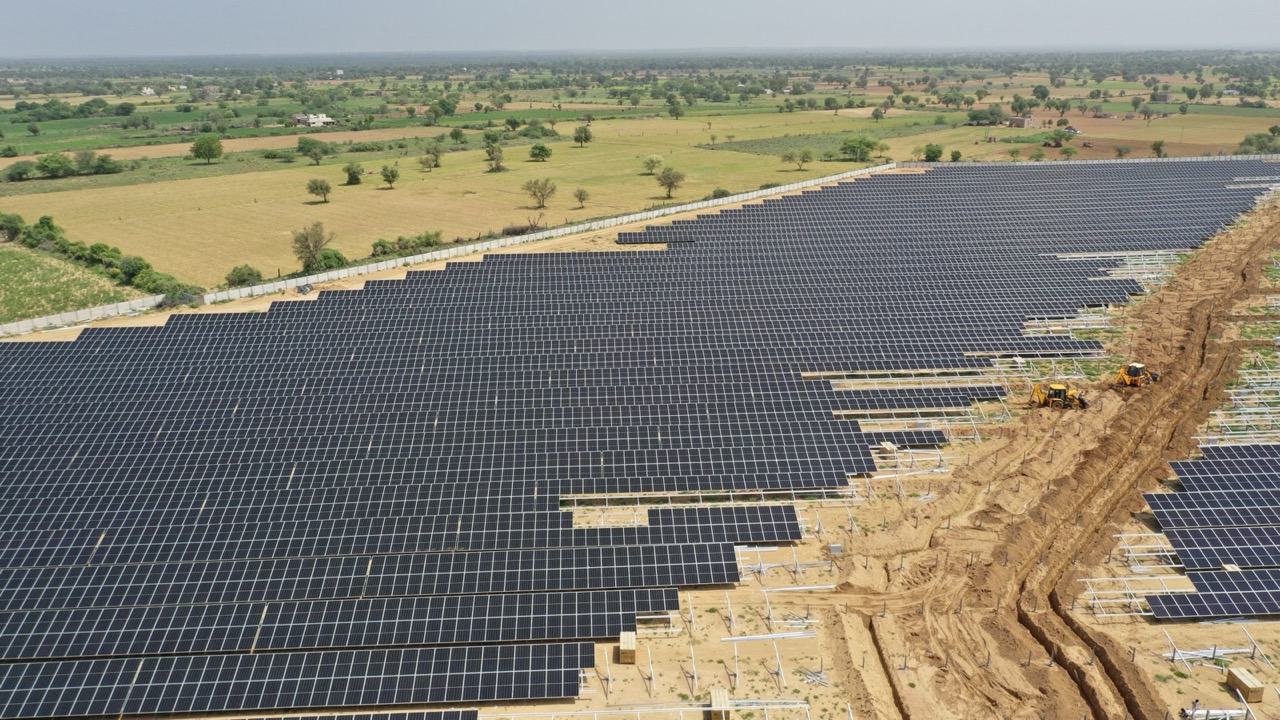

Aerial view of the 22.5 MWp solar plant under construction at Chamu, Rajasthan, the array sweeping towards farmland on the horizon
22.5 MWp + 7.5 MWh
Chamu, Jodhpur district, Rajasthan · Under construction

Solar stops at sunset. The load does not.

A 22.5 MWp captive plant on about 55 acres of open Rajasthan, with 7.5 MWh of battery storage designed into the same 33 kV interconnection rather than bolted on later. The battery charges on surplus generation through the middle of the day and discharges into the evening peak — so more of what the plant makes is consumed on site, and less of the most expensive block of the day is bought from the grid.

22.5 MWpDC, on about 55 acres
7.5 MWhBattery storage, our own scope
38,136Modules at 590 Wp

See the site film and the build

Rooftop solar array across the ATL Battery Technology manufacturing plant at Sohna, Haryana
2.7 MWp
Sohna, Haryana · ATL Battery Technology

They wanted the electricity, not the asset.

A battery manufacturer with capital better spent on its own lines. We funded, built and now own the plant; they pay only for the units they consume, under a 25-year power purchase agreement. No capex, no O&M contract to manage, no residual-value risk.

RESCOWe own it, they buy the units
25 yearsPPA tenor

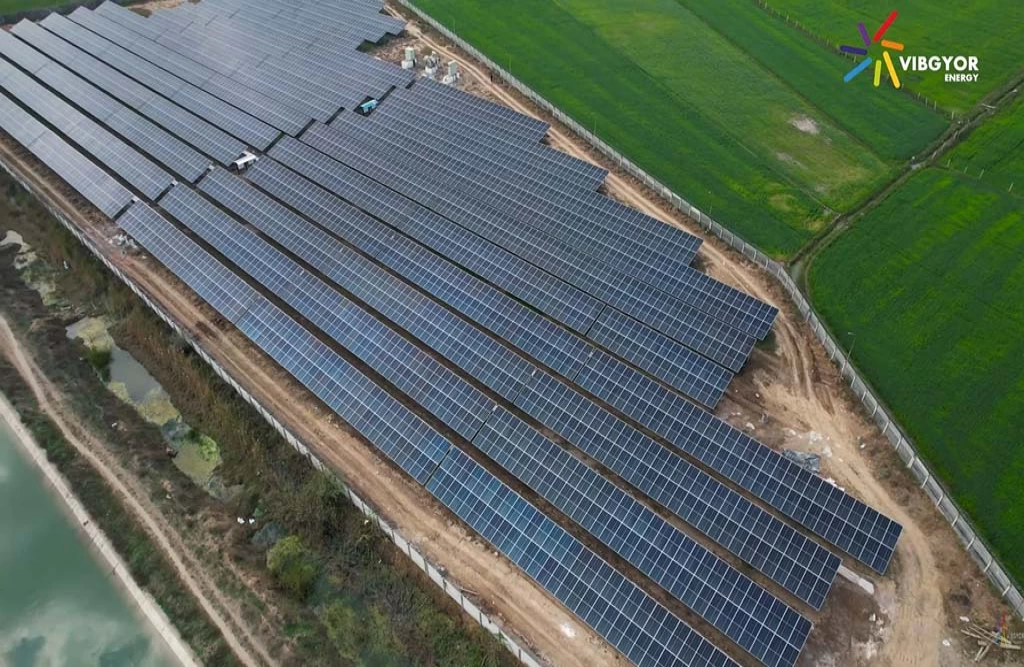

Aerial view of the Kota plant in Rajasthan, solar modules across factory roofs with a ground-mount array on open land alongside
6.5 MWp
Kota, Rajasthan · Varun Beverages

The roof ran out before the load did.

The roof could carry a serious plant, but not enough of one to move the site's bill meaningfully — so we did not stop at the roof. The rooftop array and a ground-mount array on adjoining land were engineered as one plant behind one interconnection.

6.5 MWpAcross both formats, one plant
Rooftop + groundTwo structures, one interconnection

Capacities are as commissioned. Generation and CO₂ figures are modelled at 1,350 kWh/kWp/year on a P90 basis and at the CEA grid emission factor of 0.71 t CO₂/MWh; actual output is governed by the performance guarantee in the contract, not by these figures.

Beyond the roofline

When the roof runs out, we build the plant somewhere else.

Ground-mount parks developed on land we aggregate ourselves, wheeled to your meter under group captive or open access.

Client story
The system was designed around our operations, so commissioning did not disrupt production.
Varun Beverages Limited on its 5.5 MWp rooftop plant at Supa, Maharashtra. A listed multinational present in fourteen countries, and PepsiCo's second-largest franchisee outside the United States.
23Plants delivered and operating
~69 MWCumulative solar built
2016Year the first roof went up
Repeat ordersHow almost all of it was won
Scale

Where the megawatts actually are.

We publish the shape of the portfolio rather than a directory of it. Client sites, capacities and commercial terms stay between us and the client — what is useful to you is whether we have built at your scale, in your state, under your grid code.

100+ MWp Commissioned and generating
74+ Projects delivered
22 Indian states, plus 5 countries beyond India
350+ GWh Generated to date across the fleet

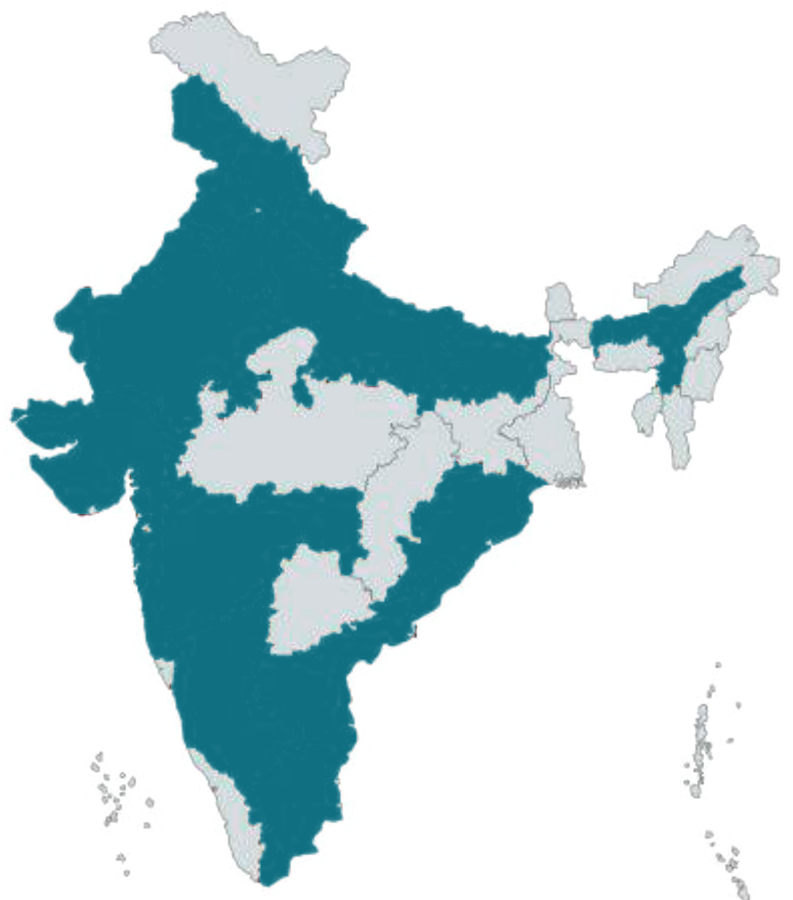

Map of India with the states in which Vibgyor Energy has delivered projects shaded in
                  teal, spanning the north, west, east, south and north-east
States we have delivered in, shaded. Five further countries — Nepal, Sri Lanka, DRC, Zambia and Zimbabwe — sit outside this frame. Base map © mapchart.net

C&I capacity by location

Solid: commissioned · hatched: under construction · plants of 200 kWp and above

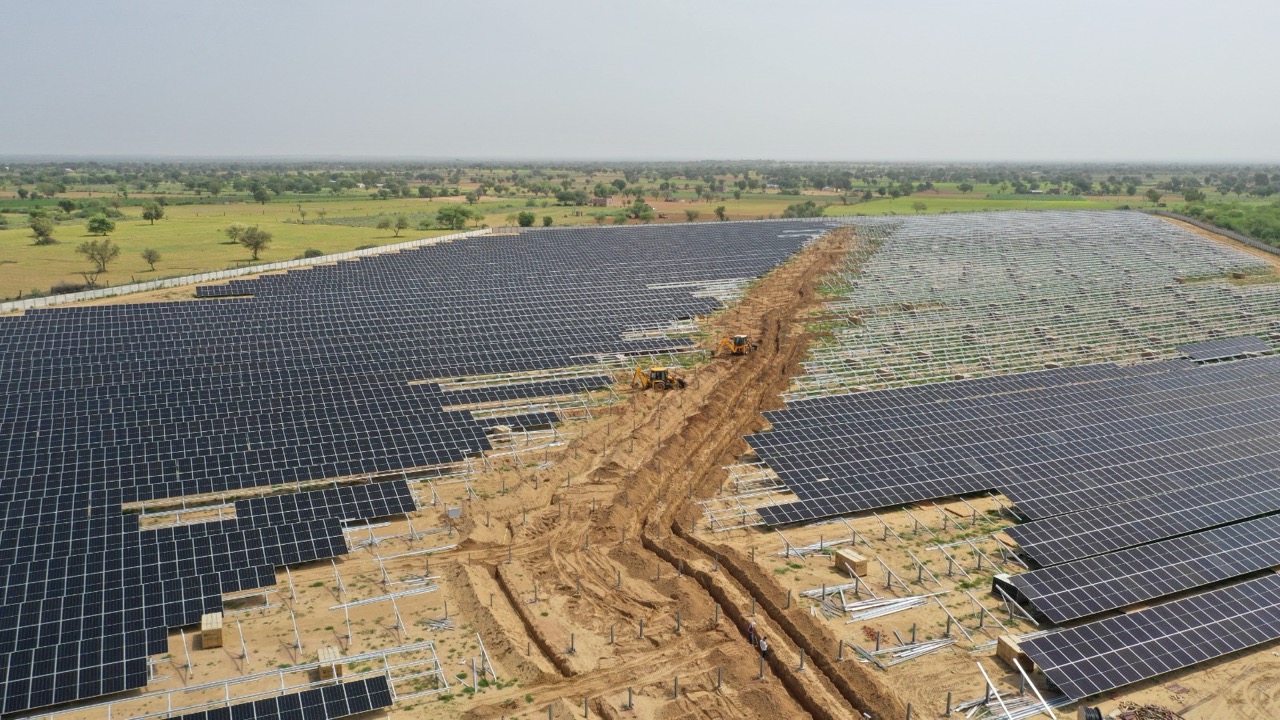

Rajasthan's hatched segment is the 22.5 MWp Chamu captive park, wheeled under open access — under construction, nearing COD — on commissioning it becomes the single largest asset in the portfolio.

Who we build for

Beverage and food processing, healthcare, automotive components, precision manufacturing and battery manufacturing — loads that run hard, where an hour of downtime costs more than the plant saves in a week.

The size we start at

200 kWp on site. Below that the engineering overhead we insist on stops making sense for the client, and there are better people to call.

What is not on this chart

Solar parks under development and generation we own on our own balance sheet. Those sit outside the commissioned C&I figure rather than being blended into it.

How the economics change by industry is set out under sectors we serve, and how land and grid connectivity are secured under project development. Capacity by location covers commissioned commercial and industrial installations of 200 kWp and above. Headline figures per the Vibgyor Energy Corporate Profile, July 2026. Client references are available under NDA during diligence.

Beyond India

One delivery standard, five countries.

Much of it for global beverage majors' franchise operations — the same client trusting us across borders.

DRC CongoKinshasa — 1,852 kWp
Phase 2 — 2,512 kWp
ZambiaLusaka — 2,290 kWp
ZimbabweHarare — 2,474 kWp
NepalParasi — 2,045 kWp
Sri LankaColombo — 1,088 kWp
Embulgama — 1,130 kWp
